How to Create Gantt Chart for Multiple Projects in Excel (with Easy Steps)

Get FREE Advanced Excel Exercises with Solutions!

If you are looking for some special tricks to make a Gantt chart for multiple projects in Excel, you’ve come to the right place. There is one way to create a Gantt chart for multiple projects in Excel. This article will discuss every step of this method to make a Gantt chart for multiple projects in Excel. Let’s follow the complete guide to learn all of this.


Download Practice Workbook

Download this practice workbook to exercise while you are reading this article. It contains all the datasets in different spreadsheets for a clear understanding. Try yourself while you go through the step-by-step process.


Step-by-Step Procedure to Create Gantt Chart for Multiple Projects in Excel

In the following section, we will use one effective and tricky method to make a Gantt chart for multiple projects in Excel. To create a more understandable Gantt chart, at first, we organize our dataset, then create a stacked bar chart, and finally, customize the graph by adding graph elements and editing the graph layout. This section provides extensive details on this method. You should learn and apply these to improve your thinking capability and Excel knowledge. We use the Microsoft Office 365 version here, but you can utilize any other version according to your preference.


Step 1: Prepare Dataset

Here, we will demonstrate how to create a Gantt chart for multiple projects in Excel. Let us first introduce you to our Excel worksheet so that you are able to understand what we are trying to accomplish with this article.

  • In the following image, we can see the basic outlines of the dataset.
  • Here, we have Project Name, Task Name, Start Date, Finish Date, Duration, and Progress columns in the following dataset.
  • In the Project Name column, we enter each project name.
  • Then, in the Task Name column, each project’s different task.
  • In the Start Date column, we enter the date when the Task of the specific project starts.
  • In the Finish Date column, we enter the date when the Task of the specific project ends.
  • We get the Duration column by subtracting the date start date from the finish date.
  • In the Progress column, we enter each task’s progress status.

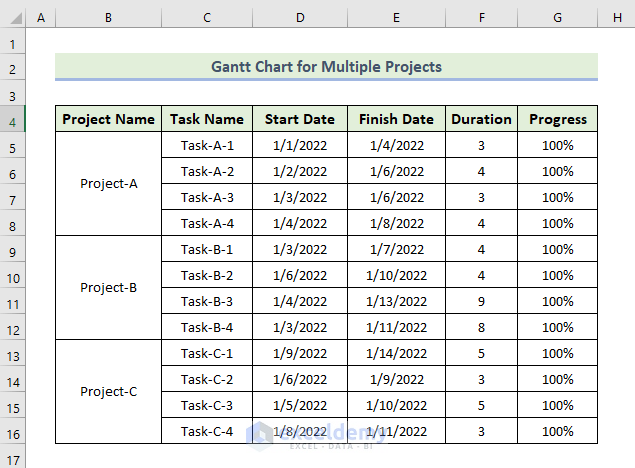

Prepare Dataset


Step 2: Create Stacked Bar Chart

Now, we are going to insert a stacked bar chart for our dataset. To do this you have to do the following process.

  • First of all, select the range of the cells D4:D16.

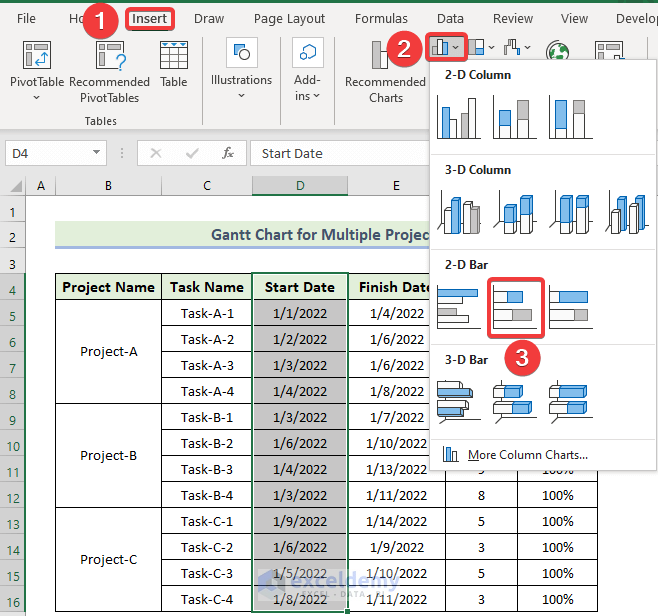

  • Now, in the Insert tab, click on the drop-down arrow of the Insert Column or Bar Chart from the Charts group.
  • Then, choose the Stacked Bar Chart.

Create Stacked Bar Chart

  • By default, you will get the following chart. Make the chart a little bit wider to get more space to work.

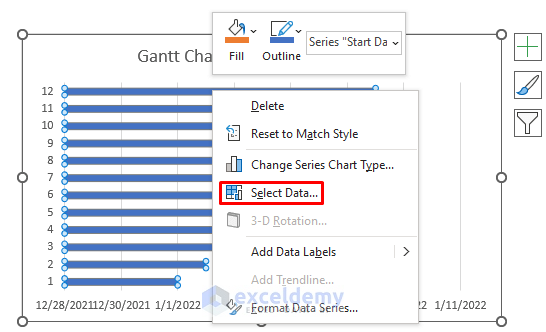

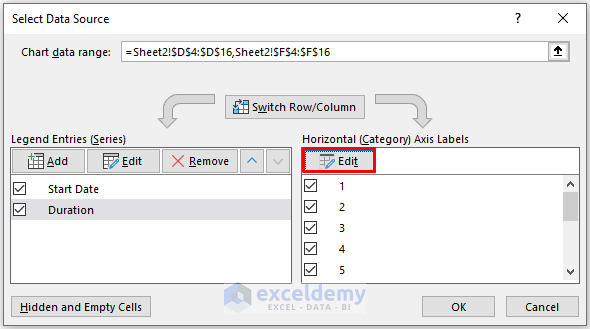

  • Next, right-click on the chart and click on Select Data to add other data series on the X-axis and Y-axis

Gantt Chart for Multiple Projects in Excel

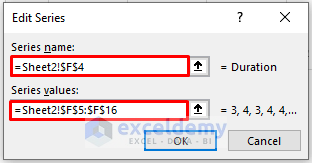

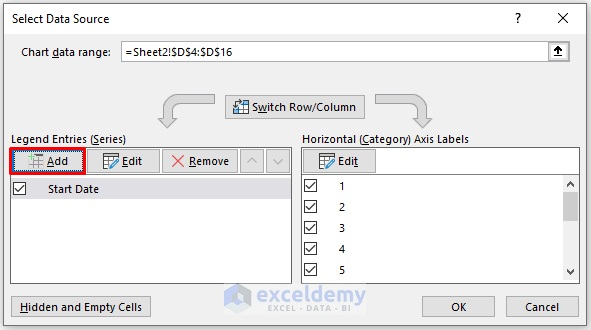

  • When the Select Data Source appears, click on Add to another data series as shown below.

  • Then, you will get the Edit Series window, where you have to enter the new data series column name on the Series name box and select values on the Series values box.
  • Next, click on OK.

  • Next, click on Edit from the Horizontal (Category) Axis Labels.

Gantt Chart for Multiple Projects in Excel

  • Afterward, the Axis Labels window will appear, where Task Name column data must be entered.

  • As a result, you will get the following chart.

Gantt Chart for Multiple Projects in Excel

Read More: How to Create Excel Gantt Chart with Multiple Start and End Dates


Step 3: Reverse Category Axis Order

In this step, we are going to reverse the category axis order. To do this, you have to follow the following process.

  • On the Category Axis (in the chart the Vertical Axis), the “Task-C-4” takes a position at the top, but the “Task-A-1” should be on the top.

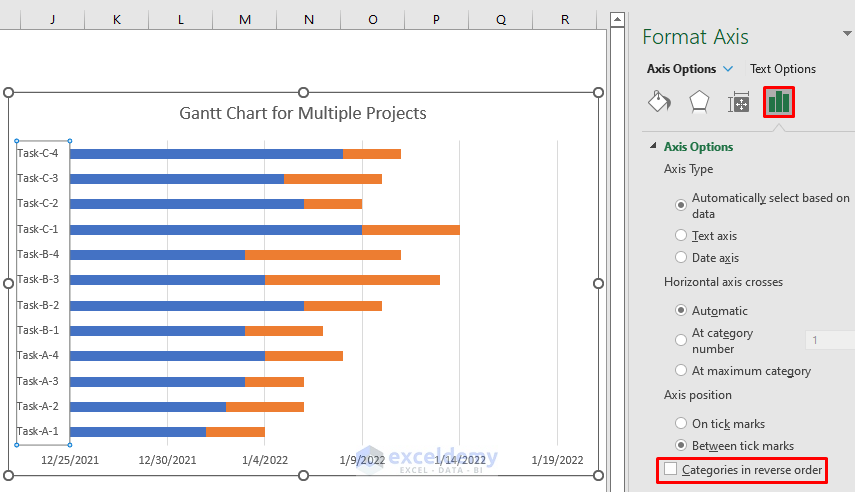

  • To reverse the order double-click on the Category Axis, and the Format Axis task pane appears. In the Axis Options tab, select the Categories in reverse order.

Gantt Chart for Multiple Projects in Excel

  • Therefore, you will get the following chart.


Step 4: Change Label Position on Horizontal Axis

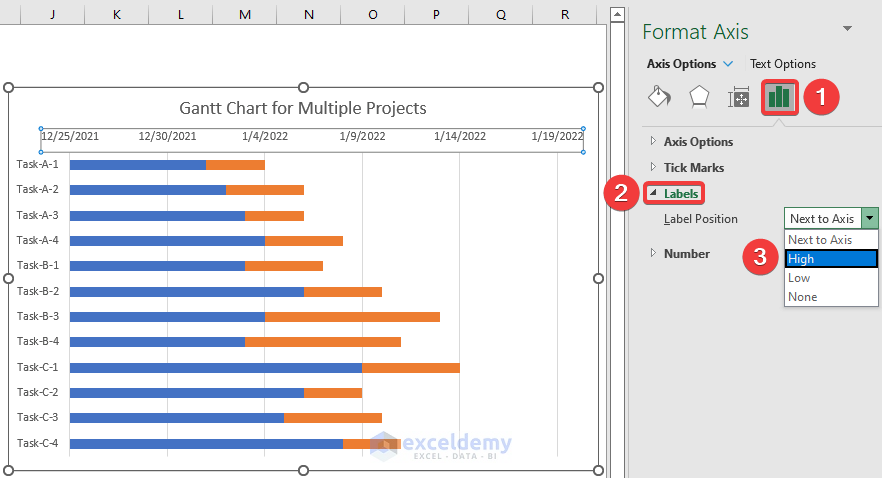

In addition, the Horizontal Axis (value axis) changes location when you reverse the Category order. Again, click the Category Axis in the Format Axis task pane, and under the Axis Options tab, select High in the Label Position option.

Gantt Chart for Multiple Projects in Excel

  • As a consequence, you will get the following chart.

  • select the blue bars. In the chart below, you see all the Blue Bars are selected.
  • Next, in the Format Data Series task pane and in the Fill & Line tab, select No Fill.

Gantt Chart for Multiple Projects in Excel

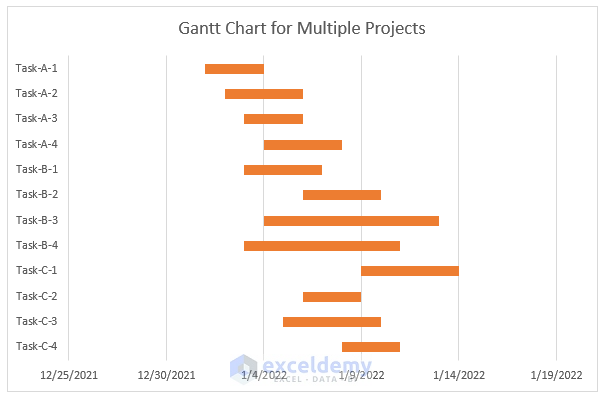

  • Take a look at the chart below. As you can see, we’ve already got a Gantt chart.


Step 5: Change Minimum, Maximum and Major Values of Horizontal Axis

Now, we are going to change the Minimum, Maximum, and Major Values of the Horizontal Axis. To do this you have to follow the following rules.

  • Now our first task of the Project “Task-A-1” starts on the date 01/01/2022, so our horizontal axis will start from this date. So, double-click on the horizontal axis, and the Format Axis task pane appears.
  • Next, in the Axis Options, the minimum value is set as 44562; we know that this “44562” is actually representing the date  01/01/2022. The maximum value is automatically set, but we change it to 44582. And we change major units to 2.

Gantt Chart for Multiple Projects in Excel

  • In order to present the horizontal axis in a more presentable way, click on the Number option, and change your required date format from the Type option.

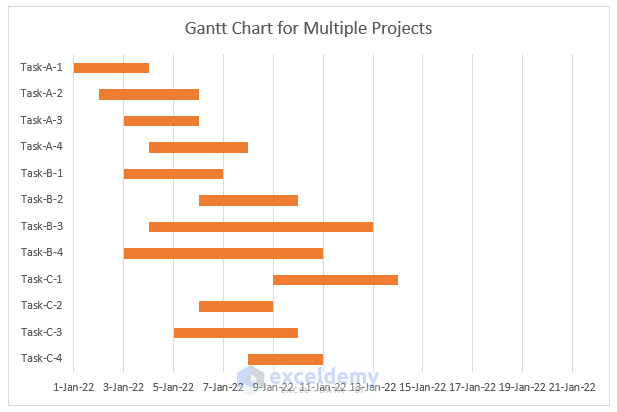

  • Therefore, you will get the following Gantt chart.

Gantt Chart for Multiple Projects in Excel


Step 6: Format Gantt Chart

It is now time to format the above chart. To format the Gantt chart, you have to follow the following process.

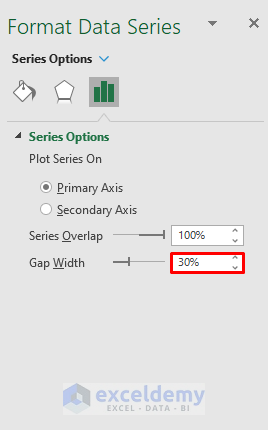

  • Choose any of the red bars from the Duration data series, then click the Format Data Series task pane. Under Series Options, change the Gap Width value to 30%. It will decrease the Gap between the Category Axis position.

Format Gantt Chart

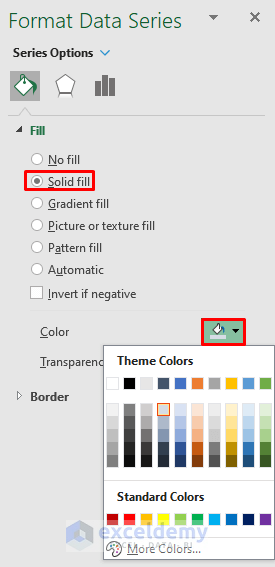

  • Next, in the Format Data Series, you have to select Fill & Line and then choose Solid Fill. Then, you have to enter your required color for the Data series.

Gantt Chart for Multiple Projects in Excel

  • Afterward, form the Format Data Series, select 3-D Format, and select Angle type bevel from the Top Bevel drop down.

  • Next, if you want to show the Data Labels for this data series. To do that, click on the Chart Elements icon on the top-right corner of the chart. From the menu select the Data Labels option.
  • Then, change the Chart Title content to Gantt Chart for Multiple Projects and make the Chart Title bigger in size. We want to show Horizontal grid lines.
  • It is possible to use a variety of background colors for your chart area, as well as dashed grid lines. Ultimately, it’s up to you.

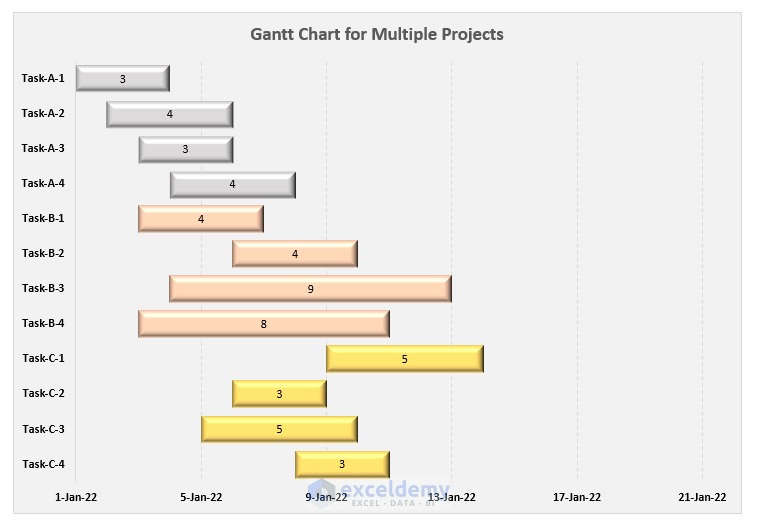

  • After Formatting, you will finally get the following Gantt chart for multiple projects in Excel.

Gantt Chart for Multiple Projects in Excel


Conclusion

That’s the end of today’s session. I firmly believe that from now you may be able to make a Gantt chart for multiple projects in Excel. If you have any queries or recommendations, please share them in the comments section below.

Don’t forget to check our website Exceldemy.com for various Excel-related problems and solutions. Keep learning new methods and keep growing!
